North Sea Pines Drive Infrastructure Improvement Project

This page will provide you with the most up-to-date information regarding the North Sea Pines Drive Infrastructure Repair Project. If your question is not addressed in the documents and resources found on this page, please send your questions or feedback to the Sea Pines CSA Maintenance Department at 843.671.7849 or email csamaintenance@csaseapines.com. Sea Pines CSA will continue to update this page with specific information and details as they are available. Thank you for your patience, as we make these necessary infrastructure and safety improvements to North Sea Pines Drive.

North Sea Pines Drive Infrastructure Improvement Project Update 1/20/2022

Project Work Zone: North Sea Pines Drive from the Sea Pines Beach Club to the Ocean Gate in Sea Pines

Completion to Date: Approximately 70% complete

Current Status:

  • Major stormwater drainage pipe removal and replacements are currently underway in the following areas:
  • In proximity to Sandhill Crane Road and Night Heron Villas
  • From Catbird Lane to Laughing Gull Road
  • From Oyster Catcher Road to Duck Hawk Road
  • Leisure trail reconstruction operations are also underway and trails in the project zone have been milled and graded and are being prepared for paving operations. Leisure trails remain closed in the project zone to accommodate this work.

What’s Next:

  • Following the completion of stormwater drainage pipe replacements and leisure trail reconstruction activities, crews will complete milling and paving operations on North Sea Pines Drive, Catbird Lane, Sandhill Crane Road, Mockingbird Lane, and a portion of Lawton Drive nearest to North Sea Pines Drive
  • Crews will also conduct line stripping, stamping of crosswalks, and site restoration with substantial project completion by the end of February 2022, weather permitting.
How to Stay Updated:
Questions:

PROJECT DETAILS AND GOALS
PROJECT PHASING
WEEKLY UPDATES


Project Details:

Sea Pines CSA has identified approximately 1.3 miles of North Sea Pines Drive from the Sea Pines Ocean Gate to the Lighthouse Road intersection to undergo extensive storm water drainage repairs, roadway and leisure trail construction/resurfacing.

Project Goals:

Key goals of the project include the following:

  • Improve traffic flow and safety
  • Increase drainage efficiency
  • Stabilize and reinforce road bed in select areas as needed
  • Resurface North Sea Pines Drive from Ocean Gate to the Lighthouse Road intersection
  • Improve roadway signage
  • Realign and widen leisure trail to improve pedestrian and bicyclist safety where needed
  • Provide new pedestrian crossings across North Sea Pines Drive

Project Phasing:

The project which will occur from Ocean Gate to the Lighthouse Road intersection and will be executed in two (2) phases:

Phase 1 Archive: Completed in April 2021. Click here to review Phase 1 project details and updates.

Phase 2 Project Details:

  • Project Work Zone: North Sea Pines Drive from the Sea Pines Beach Club to the Ocean Gate in Sea Pines.
  • Project Start Date: Work will begin in September 2021.
  • Scope of Work: Stabilizing, realigning, and resurfacing the roadway and leisure trails. Additional site work includes drainage improvements, curbing, installation, and replacement of both stamped and thermoplastic crosswalks, leisure trail widening and re-alignments, new signage and striping, tree pruning and removals, and irrigation/landscaping within the project area.

Traffic Management Plan:

  • Work will be performed Monday-Friday from 8 am-5 pm with no work occurring on major holidays.
    Weekend work may be necessary but will be communicated in advance.
  • Beginning mid-week of September 13th, we will employ alternating single lane closures on portions of North Sea Pines Drive from the Sea Pines Beach Club to the Ocean Gate as needed. In work zones flag persons will be present to control traffic.
  • Signage will be placed throughout the work zones and at various locations within the community, to communicate project messages.
  • Motorists should expect traffic delays. The project area is considered an active work zone. Please use caution while driving in this area. To avoid the project area, please use the gate located on Greenwood Drive.
  • Please observe and obey all traffic management personnel, signage and devices.
  • If you have a large truck delivery or move planned during the project period you are asked to coordinate with Sea Pines Security by calling 843.671.7170.

Commercial Traffic Restrictions:

  • We request that tri-axle vehicles avoid the Ocean Gate, when possible.
  • Tri-axle vehicles are encouraged to use the Greenwood Gate located off of Greenwood Drive for entering and exiting the Sea Pines community.

Leisure Trail Detour Map:

  • The leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. Please refer to the Leisure Trail detour map below for more information.

Vehicle Traffic Detour Map:

TEMPORARY FULL LANE CLOSURES IN PROJECT ZONE EXPECTED:

  • Owners, guests, and visitors are asked to plan accordingly and avoid the project area when possible by using the main gate located on Greenwood Drive. Pedestrians and cyclists are asked to seek alternate routes that avoid the project area. Please observe and obey all traffic management personnel, signage, and devices.

Questions?


WEEKLY UPDATES:

8/19/2021- 9/2/2021

Installation of silt fencing and tree protection along segments of the project area is underway. Project materials are being delivered and stored at Lot 8 in preparation of the project start date.


9/9/2021

  • Tree work will begin mid-week of September 13th, weather permitting.
  • Work will be performed Monday-Friday from 8 am-5 pm. Flag persons will be present to control traffic, as needed.
  • Motorists should expect traffic delays. The project area is considered an active work zone. Please use caution while driving in this area. To avoid the project area, please use the main gate located on Greenwood Drive.
  • Signage will be placed throughout the work zones and at various locations within the community, to communicate project messages.
  • Please observe and obey all traffic management personnel, signage and devices.

9/16/2021

North Sea Pines Drive Phase 2 Roadway Reconstruction Work Begins

  • Tree work along North Sea Pines Drive began Wednesday, September 15th.
  • Drainage work in proximity to Red Cardinal Road will begin the week of September 20th.
  • Work will be performed Monday-Friday from 8 am-5 pm. Flag persons will be present to control traffic, as needed.
  • Motorists should expect traffic delays. The project area is considered an active work zone. Please use caution while driving in this area. To avoid the project area, please use the main gate located on Greenwood Drive.
  • Signage will be placed throughout the work zones and at various locations within the community, to communicate project messages.
  • Please observe and obey all traffic management personnel, signage and devices.




9/23/2021

North Sea Pines Drive Phase 2 Roadway Reconstruction Underway
  • Tree work continues along the project work zone.
  • Drainage work will begin this week within the utility easements across from Beachwalk 39, between Red Cardinal Road and Whistling Swan Road.
  • Work will be performed Monday-Friday from 8 am-5 pm. Flag persons will be present to control traffic, as needed.
  • Motorists should expect traffic delays. The project area is considered an active work zone. Please use caution while driving in this area. To avoid the project area, please use the main gate located on Greenwood Drive.
  • Signage will be placed throughout the work zones and at various locations within the community, to communicate project messages.
  • Please observe and obey all traffic management personnel, signage and devices.

9/30/21

  • Tree work continues along the project work zone.
  • Drainage demolition and construction are underway near Red Cardinal Road & Beachmarker 39. The work in this area will continue throughout this week.
  • Erosion control will be installed at the beginning of next week in select areas of the roadway, leisure trails and Beachwalks along North Sea Pines Drive.
  • Work will be performed Monday-Friday from 8 am-5 pm. Flag persons will be present to control traffic, as needed.
  • Motorists should expect traffic delays. The project area is considered an active work zone. Please use caution while driving in this area. To avoid the project area, please use the main gate located on Greenwood Drive.
  • Signage will be placed throughout the work zones and at various locations within the community, to communicate project messages.
  • Please observe and obey all traffic management personnel, signage and devices.

10/7/2021
Current Week:
  • Drainage work continues in proximity to Beachwalk #39 and Red Cardinal Road.
  • Drainage work begins today, October 7th, in proximity to Beachwalk #40 (between 62 & 68 drainage easement), weather permitting.
  • Erosion control & tree protection will be installed in select areas of the roadway, leisure trails and beachwalks along North Sea Pines Drive and where the “T” streets meet North Sea Pines Drive.
Next Week: October 12-15
  • Crews will begin major stormwater drain pipe excavation and replacement next week in the areas along and across the roadway of North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road and the adjacent leisure trail.
  • Heavy traffic delays should be expected along North Sea Pines Drive as crews will utilize single-lane closures along this roadway to accommodate the work.
  • Owners, guests, and visitors are asked to plan accordingly and avoid the project area when possible by using the main gate located on Greenwood Drive. Pedestrians and cyclists are asked to seek alternate routes that avoid the project area.
  • Please observe and obey all traffic management personnel, signage, and devices.

10/14/2021

Past Week: 10/11-10/15

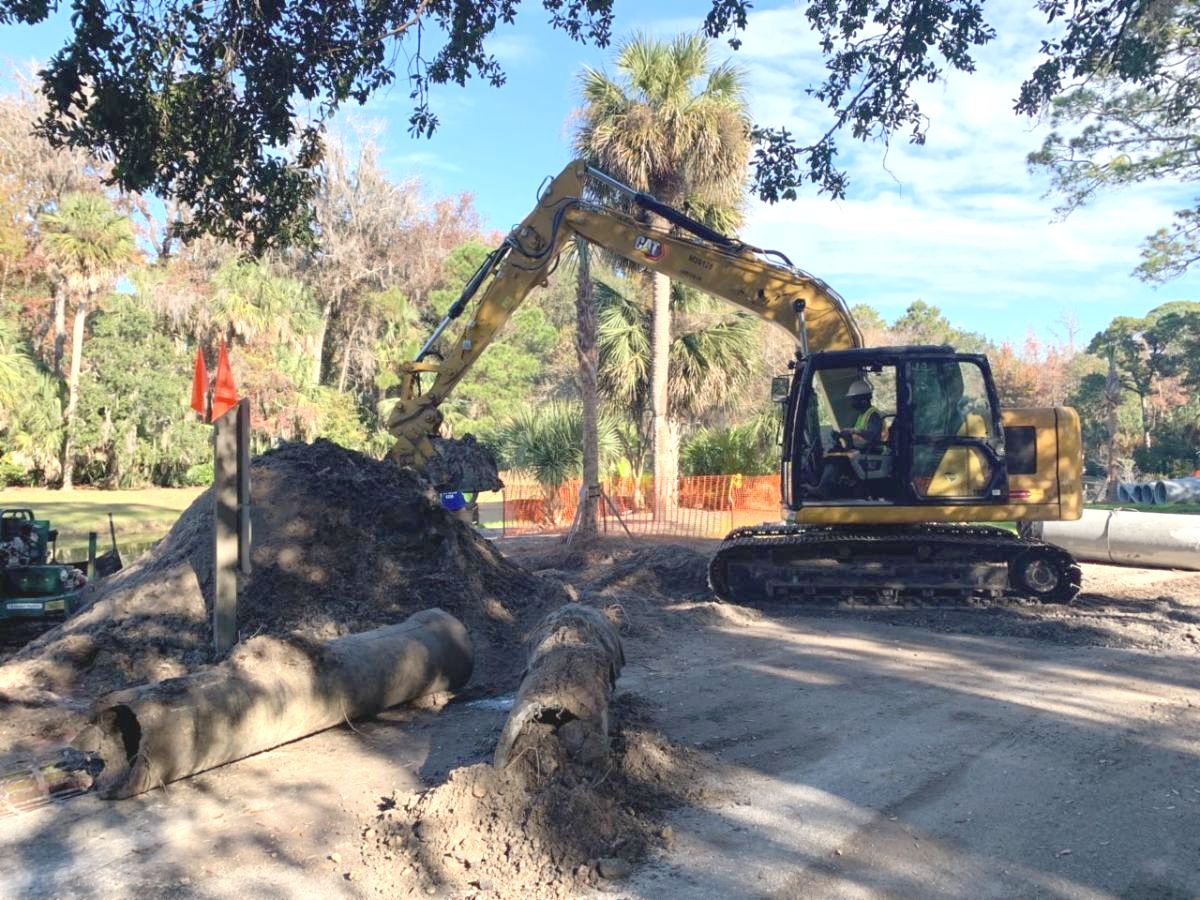

Crews work in tight quarters near Red Cardinal Road to excavate the old stormwater drainage pipe.
Photo of the excavated original stormwater drainage pipe, which is estimated to be nearly 60 years old.

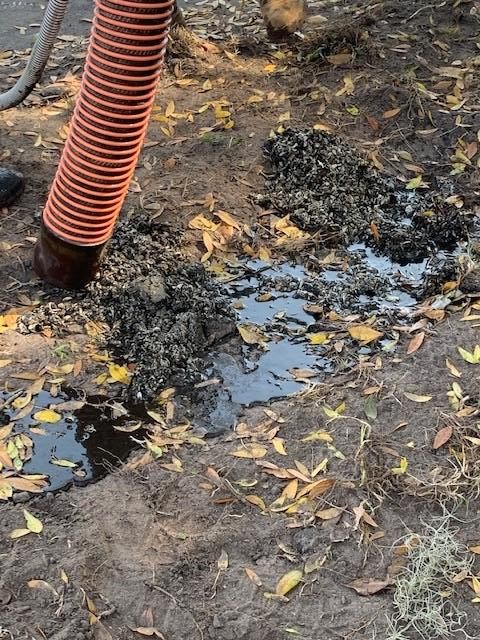

Excavated original stormwater drainage pipes which were badly deteriorated.
New replacement stormwater pipe awaiting installation.

Week of 10/18-10/22
Crews will continue major stormwater drain pipe excavation and replacement in the areas along and across the roadway of North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road and the adjacent leisure trail.
What you need to know?
  • HEAVY TRAFFIC EXPECTED/ UTILIZE GREENWOOD DRIVE GATE:
    • Heavy traffic delays should be expected on North Sea Pines Drive as crews will utilize single-lane closures along this roadway to accommodate the work.
    • Owners, guests, and visitors are asked to plan accordingly and avoid the project area when possible by using the main gate located on Greenwood Drive. Pedestrians and cyclists are asked to seek alternate routes that avoid the project area. Please observe and obey all traffic management personnel, signage, and devices.
  • TEMPORARY FULL LANE CLOSURES IN PROJECT ZONE EXPECTED NEXT WEEK/MORE DETAILS FORTHCOMING:
    • Short timed/temporary road closures in both directions along North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road will occur next week as the main stormwater drainage pipes that cross this major roadway are removed and replaced.
    • An alert will be sent in advance of these closures.
  • WATER OUTAGE EXPECTED/ MORE DETAILS FORTHCOMING:
    • Disruption to water utility services in the project zone (along North Sea Pines Drive) will occur early next week as crews conduct the removal and replacement pipework.
    • Sea Pines CSA will communicate early next week once the timing and affected areas are confirmed through South Island Public Service District.
  • REMINDER OF LEISURE TRAILS CLOSURES IN PROJECT ZONE:
    • Beginning today, October 14th, the leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. Please refer to the Leisure Trail detour map (click here)
  • We appreciate your continued patience as our crews work to conduct this critical infrastructure work. This work will make a positive impact not only in this area of the roadway along North Sea Pines Drive but will also make a significant improvement to the communities’ overall master stormwater drainage system.

10/15/21 Update

Early next week, major stormwater drain pipe excavation and replacement will occur in the areas along and across the roadway of North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road and the adjacent leisure trail. Weather permitting, below is the current schedule:
Monday, October 18:
Site Prep Work In the Roadway on North Sea Pines Drive Near Red Cardinal Road
  • Single lane closures and short-timed/temporary full road closures in both directions along North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road will be used to accommodate site prep work along the roadway.
  • Flagman will be present during the single-lane closures- Traffic detours will be in effect during the temporary full road closures.
Tuesday, October 19:
Major Stormwater Drain Pipe Removal and Replacement Planned On Tuesday Morning Near Red Cardinal Road
  • Single lane closures and temporary full road closures in both directions along North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road will be utilized as the main stormwater drainage pipes that cross this major roadway are removed and replaced.
  • This major removal and replacement work will occur on Tuesday morning, weather permitting from approximately 6:30 AM-Noon and longer full lane closures should be expected during this time period. Avoid the project work zone if possible.
  • Owners/renters with property between Red Cardinal Road to Spotted Sandpiper Road will still have access to their homes. Emergency vehicles will also still have access during this timeframe.
  • Flagman will be present during the single-lane closures- Traffic detours will be in effect during the temporary full road closures.
  • Disruption to water utility services in the project zone will occur on October 19 from approximately 6:30 AM to Noon, as crews conduct the removal and replacement pipework. The areas that will be impacted by the water outage include Fairway One Villas, Red Cardinal Road, The Sea Pines Beach Club.
General Project Reminders:
  • HEAVY TRAFFIC EXPECTED/ UTILIZE GREENWOOD DRIVE GATE:
    • Heavy traffic delays should be expected on North Sea Pines Drive as crews will utilize single-lane and full road closures as necessary along this roadway to accommodate the work.
    • Owners, guests, and visitors are asked to plan accordingly and avoid the project area when possible by using the main gate located on Greenwood Drive. Pedestrians and cyclists are asked to seek alternate routes that avoid the project area.
    • Please observe and obey all traffic management personnel, signage, and devices.
  • REMINDER OF LEISURE TRAILS CLOSURES IN PROJECT ZONE:
    • As of October 14th, the leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. We will keep you updated on its estimated reopening date.
    • Please refer to the Leisure Trail detour map by clicking here) for more information.

October 19, 2021
Water Service Restored:
  • Water utility services in the areas of Fairway One Villas, Red Cardinal Road, The Sea Pines Beach Club. have been restored as of 11:00 AM. We appreciate your patience as our crews work to conduct this critical infrastructure work.

October 21, 2021

North Sea Pines Drive Phase 2: Major Roadway Reconstruction In Progress

Major stormwater drain pipe excavation and replacements are in progress in the areas along and across the roadway of North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road and the adjacent leisure trail.

HEAVY TRAFFIC EXPECTED/ UTILIZE GREENWOOD DRIVE GATE:

  • Heavy traffic delays should be expected on North Sea Pines Drive as crews will utilize single-lane closures along this roadway to accommodate the work.
  • Stormwater drainage installation along the drainage easement in proximity to Beachwalk #40 and Spotted Sandpiper Road will be taking place on Saturday, October 23rd, weather permitting.
  • Owners, guests, and visitors are asked to plan accordingly and avoid the project area when possible by using the main gate located on Greenwood Drive. Pedestrians and cyclists are asked to seek alternate routes that avoid the project area. Please observe and obey all traffic management personnel, signage, and devices.

TEMPORARY FULL LANE CLOSURES IN PROJECT ZONE EXPECTED TO CONTINUE THROUGH THE WEEK OF OCTOBER 25TH:

  • Short timed/temporary road closures in both directions along North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road will continue through next week as the main stormwater drainage pipes that cross this major roadway are removed and replaced.

REMINDER OF LEISURE TRAILS CLOSURES IN PROJECT ZONE:

  • The leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. Please refer to the Leisure Trail detour map here for more information.
Crews working to excavate old stormwater drainage pipe
Installation of New replacement stormwater drainage pipe
Potable water line excavation along North Sea Pines Drive



10/28/2021

Major stormwater drain pipe excavation and replacements are in progress in the areas along and across the roadway of North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road and the adjacent leisure trail.
HEAVY TRAFFIC EXPECTED/ UTILIZE GREENWOOD DRIVE GATE:
  • Heavy traffic delays should be expected on North Sea Pines Drive as crews will utilize single-lane closures along this roadway to accommodate the work in and along the roadway.
  • Owners, guests, and visitors are asked to plan accordingly and avoid the project area when possible by using the main gate located on Greenwood Drive. Pedestrians and cyclists are asked to seek alternate routes that avoid the project area. Please observe and obey all traffic management personnel, signage, and devices.
TEMPORARY FULL LANE CLOSURES IN PROJECT ZONE EXPECTED TO CONTINUE THROUGH THE WEEK OF NOVEMBER 1st:
  • Short timed/temporary road closures in both directions along North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road will continue through next week as the main stormwater drainage pipes that cross this major roadway are removed and replaced.
ADDITIONAL PROJECT REMINDERS:
  • The leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. Please refer to the Leisure Trail detour map here for more information.
  • Additional erosion control & tree protection will be installed next week from Spotted Sandpiper to Ocean Gate.
  • The Beachwalks located at #39 & #40 are not currently accessible from North Sea Pines Drive due to this project.
Crews working near Beachwalk #40 to remove stormwater drainage pipe
Old deteriorated stormwater drainage pipe awaiting disposal
Crews work in tight quarters and in close proximity to the busy North Sea Pines Drive Roadway to excavate old drainage pipes.

November 4, 2021

Major stormwater drain pipe excavation and replacements are in progress in the areas along and across the roadway of North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road and the adjacent leisure trail.
HEAVY TRAFFIC EXPECTED/ UTILIZE GREENWOOD DRIVE GATE:
  • Heavy traffic delays should be expected on North Sea Pines Drive as crews will utilize single-lane closures along this roadway to accommodate the work in and along the roadway.
  • Owners, guests, and visitors are asked to plan accordingly and avoid the project area when possible by using the main gate located on Greenwood Drive. Pedestrians and cyclists are asked to seek alternate routes that avoid the project area. Please observe and obey all traffic management personnel, signage, and devices.
TEMPORARY FULL LANE CLOSURES IN PROJECT ZONE EXPECTED:
  • Short timed/temporary road closures in both directions along North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road will continue through next week as the main stormwater drainage pipes that cross this major roadway are removed and replaced.
ADDITIONAL PROJECT REMINDERS:
  • The leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. Please refer to the Leisure Trail detour map here for more information.
  • The Beachwalks located at #39 & #40 are not currently accessible from North Sea Pines Drive due to this project.
Crews excavating and removing an old drain pipe along North Sea Pines Drive
Crews conduct drainage installation across North Sea Pines Drive near Red Cardinal Road

November 11, 2021-

Major stormwater drain pipe excavation and replacements continue in the areas along and across the roadway of North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road and the adjacent leisure trail.

PROJECT REMINDERS:

  • TEMPORARY FULL LANE CLOSURES IN PROJECT ZONE ARE EXPECTED. UTILIZE GREENWOOD DRIVE GATE TO AVOID HEAVY TRAFFIC DELAYS.
  • The leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. Please refer to the Leisure Trail detour map here for more information.
  • The Beachwalks located at #39 & #40 are not currently accessible from North Sea Pines Drive due to this project.

November 18, 2021

Major stormwater drain pipe excavation and replacements are in progress in the areas along and across the roadway of North Sea Pines Drive between Red Cardinal Road to Spotted Sandpiper Road and the adjacent leisure trail. Work will be conducted Monday-Wednesday of next week.

PROJECT REMINDERS:

  • TEMPORARY FULL LANE CLOSURES IN PROJECT ZONE ARE EXPECTED. UTILIZE GREENWOOD DRIVE GATE TO AVOID HEAVY TRAFFIC DELAYS.
  • The leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. Please refer to the Leisure Trail detour map here for more information.
  • The Beachwalks located at #39 & #40 are not currently accessible from North Sea Pines Drive due to this project.

Catbird Lane & Spotted Sandpiper Road Drainage Work to begin November 29th

Sea Pines CSA’s contractor will begin well point operations the week of November 29th to remove groundwater before excavation.

  • Well point pumps and equipment will be set up in the roadway.
  • Work is expected to take 2 weeks, weather permitting.

Sea Pines CSA will continue to keep the community updated throughout this project through our community emails and our website at www.seapinesliving.com/seapinesdrive.

Construction crews will conduct major infrastructure improvement work near the Ocean Gate in Sea Pines the week of December 6th. This portion of the work occurring in the inbound lane is expected to take approximately 3 days to complete, weather permitting.

Due to limitations on working space and the need to excavate stormwater drainage pipe and install replacement pipe, the inbound lane of traffic at the Ocean Gate (Cordillo Pkwy. At South Forest Beach Drive) will be closed from 7:00 am to 5:00 pm during the work.

Drivers coming inbound into Sea Pines will need to use the Greenwood Gate located off of the Sea Pines Circle during the stated timeframe. Traffic control and flaggers will be present during this work, drivers are asked to use caution in the work zone. Leisure trails in this area of North Sea Pines Drive and the Ocean Gate will be closed in both directions to accommodate this work.

Sea Pines CSA will continue to keep you updated and will provide additional details and firm dates on this planned work and lane closures as we near the week of December 6th.


Weekly Updates:

December 9, 2021:

Sea Pines CSA’s contractors continue conducting Major Roadway and Infrastructure Reconstruction Improvements along North Sea Pines Drive.

Due to limitations on working space and the need to excavate stormwater drainage pipe and install replacement pipe, periodic lane closures at the Ocean Gate (located at Cordillo Parkway and South Forest Beach Drive) will be utilized.

Ocean Gate Drainage Work

Discovery of Utility Conflicts in Project Zone Causes Schedule Update to Sea Pines Ocean Gate Lane Closures

  • Inbound Lane Closures at the Ocean Gate will continue through Friday, December 10 from 7a-5p.
  •  Work at the Ocean Gate will not occur over the weekend and both lanes will be open (December 11th – 12th)
  • The Outbound Lane Closure at the Ocean Gate will begin Monday, December 13th. The stormwater drainage work will take approximately 3 days to complete, weather permitting. The outbound lane will be CLOSED from 7 AM – 5 PM, December 13th through December 15th.

Click here to view the most recent update on this work.


Spotted Sandpiper Road Drainage Work
Work continues on Sandpiper Road. This work is expected to take 1-2 weeks, weather permitting. Drainage work on Catbird Lane will follow.


General Project Reminders

  • North Sea Pines Drive Roadway Reconstruction will continue through January. Heavy traffic delays should be expected on North Sea Pines Drive as crews will utilize single-lane and temporary full lane closures along this roadway to accommodate the work. Traffic control will be in place, obey the speed limit within the construction zone.
  • The leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. Please refer to the Leisure Trail detour map here for more information.
  • The Beachwalks located at #39 & #40 are not currently accessible from North Sea Pines Drive due to this project.
  • Sea Pines CSA will continue to keep the community updated throughout this project through our community emails and our website at www.seapinesliving.com/seapinesdrive.

December 16, 2021

Ocean Gate Drainage Work
Crews successfully completed stormwater drainage pipe excavation and installation across the roadway on North Sea Pines Drive in proximity to the Ocean Gate. Crews will continue working in the Ocean Gate area next week, weather permitting.
Spotted Sandpiper Road Drainage Work

Drainage work continues on Sandpiper Road and will continue through the end of the week, weather permitting. Well-point operations on Catbird Lane will begin on Monday, December 20th.

Pictured below: Sea Pines CSA’s contractor works around utility conflicts during drainage work on Spotted Sandpiper Road.


December 21, 2021

Sea Pines CSA’s contractors continue conducting Major Roadway and Infrastructure Reconstruction Improvements along North Sea Pines Drive.

Work will not be conducted on the following days: December 24, December 25, December 31 or January 1.

Sandhill Crane Road Drainage Work

  • Drainage work in proximity to Beachwalk 45 and Sandhill Crane Road began this week.
  • Single-lane road closures are scheduled to begin the week of January 3rd, flagging operations will be in place.
  • The leisure trail remains closed.
Catbird Lane Drainage Work
  • Well-point operations on Catbird Lane began Monday, December 20th to remove groundwater before pipe excavation and will continue through Thursday, December 23rd.

December 30, 2021

Sea Pines CSA’s contractors will continue conducting Major Roadway and Infrastructure Reconstruction Improvements along North Sea Pines Drive through January 2022.

Potable Water Line Shutdown Scheduled for the Week of January 3rd

  • Due to a water line conflict in proximity to new drainage pipe installation, Sea Pines CSA contractors in conjunction with South Island Public Service District will be executing a potable water line shut down the week of January 3rd in proximity to Spotted Sandpiper Road and Whistling Swan Road.
  • South Island Public Service District does not expect Property Owners to be affected by the water line shutdown.
Alternating single-lane road closures will begin Monday, January 3rd, and will continue through Friday, January 7th
  • Heavy traffic delays should be expected on North Sea Pines Drive next week as crews will utilize single-lane closures along this roadway to accommodate the work. Traffic control will be in place, obey the speed limit within the construction zone.

Sandhill Crane Road & Catbird Lane Drainage Work

Drainage work in proximity to Sandhill Crane Road and Night Heron Villas is in progress. The leisure trail remains closed.

  • Drainage installation on Catbird Lane is in progress and will continue through the week of January 3rd.

1/6/2022

Sandhill Crane Road & Catbird Lane Drainage Work

  • Drainage work in proximity to Sandhill Crane Road and Night Heron Villas is in progress. The leisure trail remains closed.
  • Drainage installation on Catbird Lane is in progress and will continue through the week of January 10th.

Red Cardinal Road Survey Work

  • Survey work will take place on Red Cardinal Road the week of January 10th.
  • No traffic delays or detours are expected.




January 13, 2022

Sea Pines CSA’s contractor began setting up for well point operations from Oyster Catcher to Duck Hawk as well as from Laughing Gull towards Catbird Lane today, January 13th. Drainage pipe installation will begin on these sections of the roadway Tuesday, January 18th, weather permitting.

Sandhill Crane Road & Catbird Lane Drainage Work

  • Drainage work in proximity to Sandhill Crane Road and Night Heron Villas is in progress. The leisure trail remains closed.
  • Drainage pipe installation on Catbird Lane is in progress and will continue through the end of this week. (Pictured below)
General Project Reminders

  • Heavy traffic delays should be expected on North Sea Pines Drive as crews will utilize single-lane closures along this roadway to accommodate the work. Traffic control will be in place, obey the speed limit within the construction zone.
  • The leisure trail along North Sea Pines Drive from The Sea Pines Beach Club to Lawton Drive is closed to bike and pedestrian traffic. Please refer to the Leisure Trail detour map here for more information.
  • The Beachwalks located at #39 & #40 are not currently accessible from North Sea Pines Drive due to this project.
  • Sea Pines CSA will continue to keep the community updated throughout this project through our community emails and our website at www.seapinesliving.com/seapinesdrive.
